Read the postOpen up a room, add space, or repair damaged framing. Start with the structure and build from a clear design.
Opening a room or repairing damaged framing starts with understanding how the house carries its loads. We build the structural work from an accepted design, with the supporting trades, temporary protection, and inspection stages included in the plan.

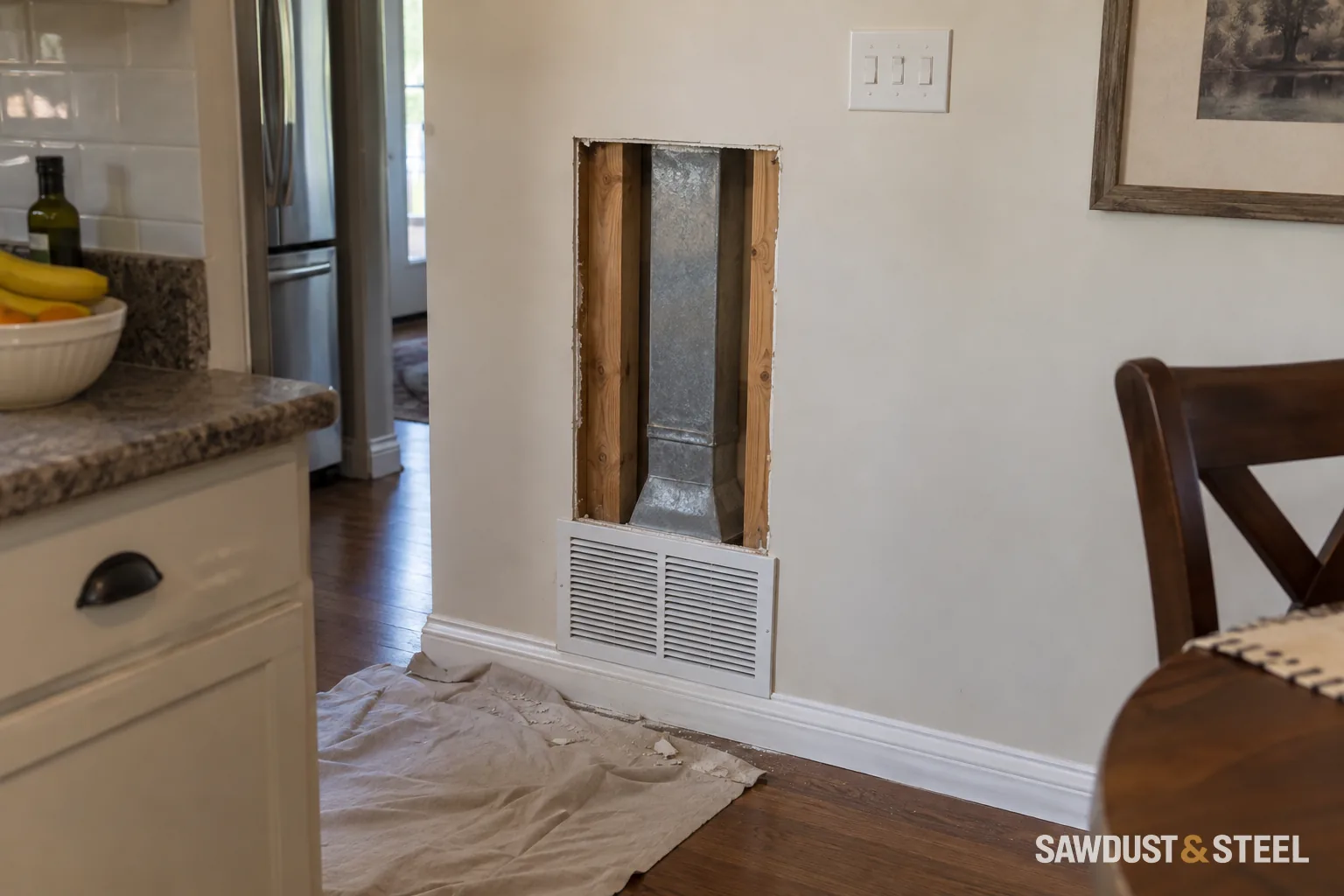

Structural changes affect more than the wall you can see. A new opening can require beams, posts, connections, and foundation work, as well as changes to wiring, plumbing, or ducts.
Existing damage needs a cause established before a repair is priced. New or worsening movement belongs with a qualified structural assessment.
Bring the drawings and any reports you have. Where the design is still being developed, identify what must be investigated before the construction scope can be settled.

Sam and Leila wanted the kitchen wall completely gone. Their sketch showed one wide room and a flush ceiling. The structural review introduced a less photogenic list: beam depth, bearing points, the support below, and a duct sitting directly in the proposed opening.
One option chased the flush ceiling through a larger scope. The other kept a short return at one end and allowed a visible beam. They chose the second. It preserved a useful cabinet run and kept the project focused on the opening they actually needed.
During the work, an exposed connection differed from the drawing. The affected installation paused while the designer reviewed it. The change was recorded before work continued. Annoying in the moment, certainly, but better than building a finish around an unanswered question.
Once the beam was boxed and painted, it gave the dining area a natural edge. Leila placed the table beneath it. The feature they had hoped to hide became the part that helped the larger room feel settled.
“We thought open-plan meant removing everything. Keeping that little return made the kitchen work.”
A wall removal concentrates loads at new bearing points. The designer must trace them through the beam, connections, posts, and supports below to suitable foundations. The diagram explains the principle; the actual members and connections belong in the project-specific design.

Temporary support carries real loads while the existing structure changes. Its layout, foundations, installation sequence, and removal need project-specific planning and required reviews. Confirm those stages before work starts, including who accepts the permanent work before temporary support comes down.
Framing, load-bearing openings, beam and post installation, structural repairs, room additions, and second-storey construction. The accepted design establishes what can remain and what must change. Include demolition, temporary protection, trade coordination, inspections, and finish restoration when comparing scopes.
The engineer’s role is to take responsibility for the engineering design within an agreed scope. Our construction scope needs the current drawings, details, and review requirements before affected work starts.
Verify the practitioner and firm through the PEO directory. Agree who handles permit comments, site questions, revisions, and field reviews. Keep the final signed and sealed documents with the project records.
If the opened structure differs from the drawings, refer the condition back to the responsible designer. Any revised work, price, and schedule effect should be documented before proceeding.
Often, with an accepted structural design and required approvals. The opening width, loads, supports below, services, and desired ceiling finish all affect feasibility and cost.
Confirm those responsibilities in the project quote. It should name the required design work, permit application, inspection bookings, field reviews, and final records, including any separately contracted services.
Temporary support and sequencing are designed for the actual loads and existing conditions. There is no safe universal arrangement for every wall removal. Required professional reviews apply before support is changed or removed.
The affected work needs assessment, photographs, and a clear repair decision. Structural conditions go back to the designer; regulated trade work goes to the appropriate provider. Record approved changes before covering the area.
We offer addition and framing work. Feasibility starts with zoning, existing structural capacity, stairs, building services, and weather protection. Complete that review before relying on a construction estimate.

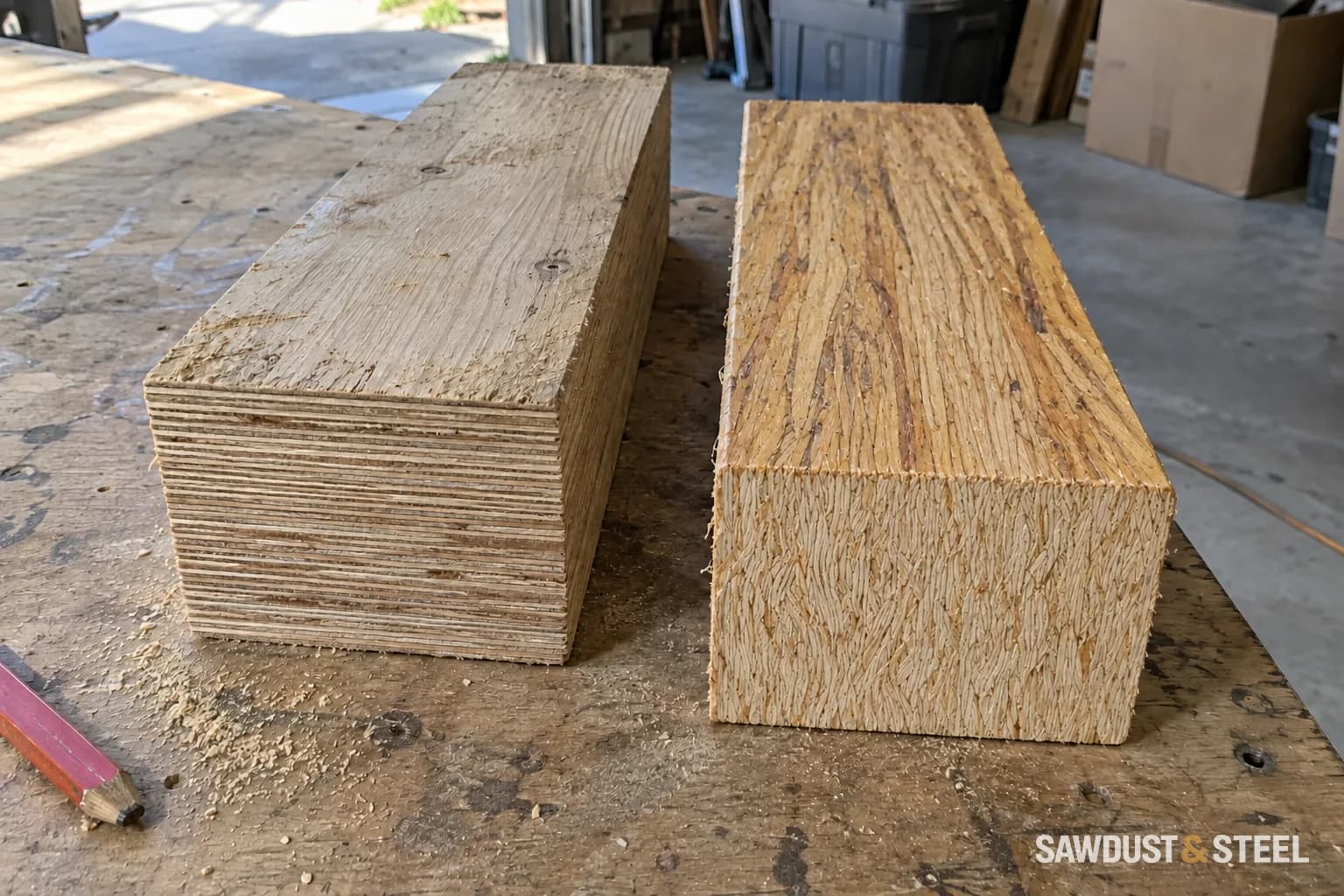

PSL and LVL are both engineered wood, but beam dimensions, handling, connections, and appearance can change the renovation around them.
